Construction Update – The Tower – July 2018

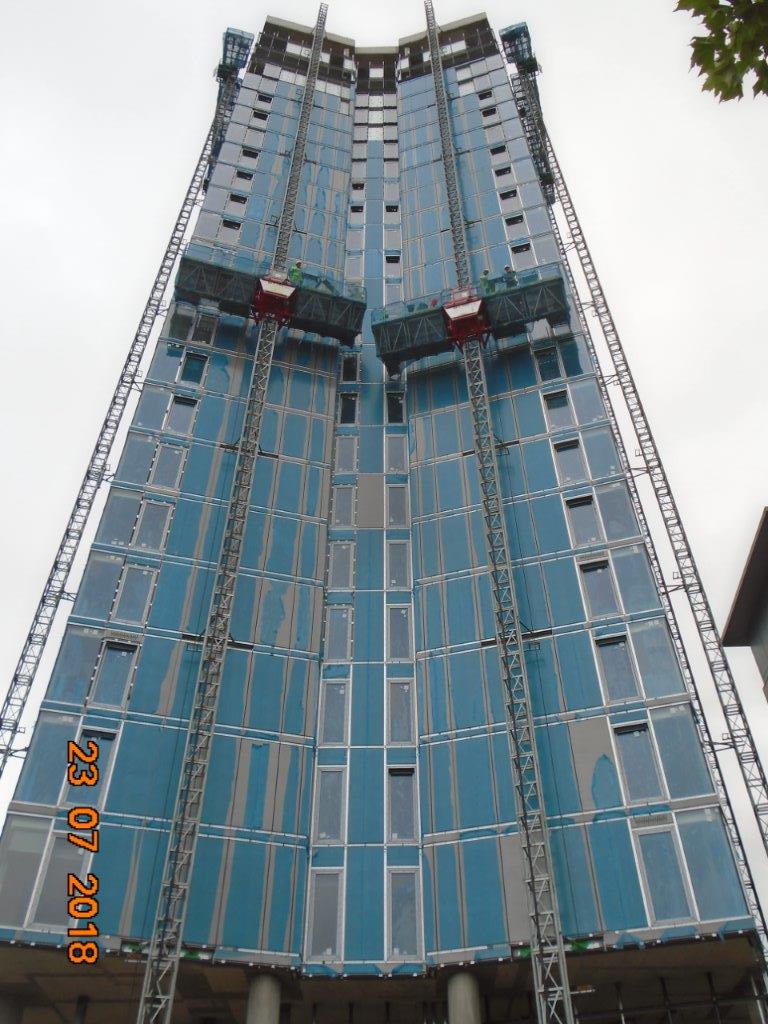

27th July 2018This month, curtain walling grid installation commenced on the top three floor’s of the tower, levels 21-23. The aluminium panels have been installed up to level 17 on all elevations. Partitions have commenced internally on level 18 with M&E currently working on levels 8-12. Kitchens and tiling completed on level 7 along with flooring and joinery.
