Construction Update – The Tower – December 2017

26th December 2017

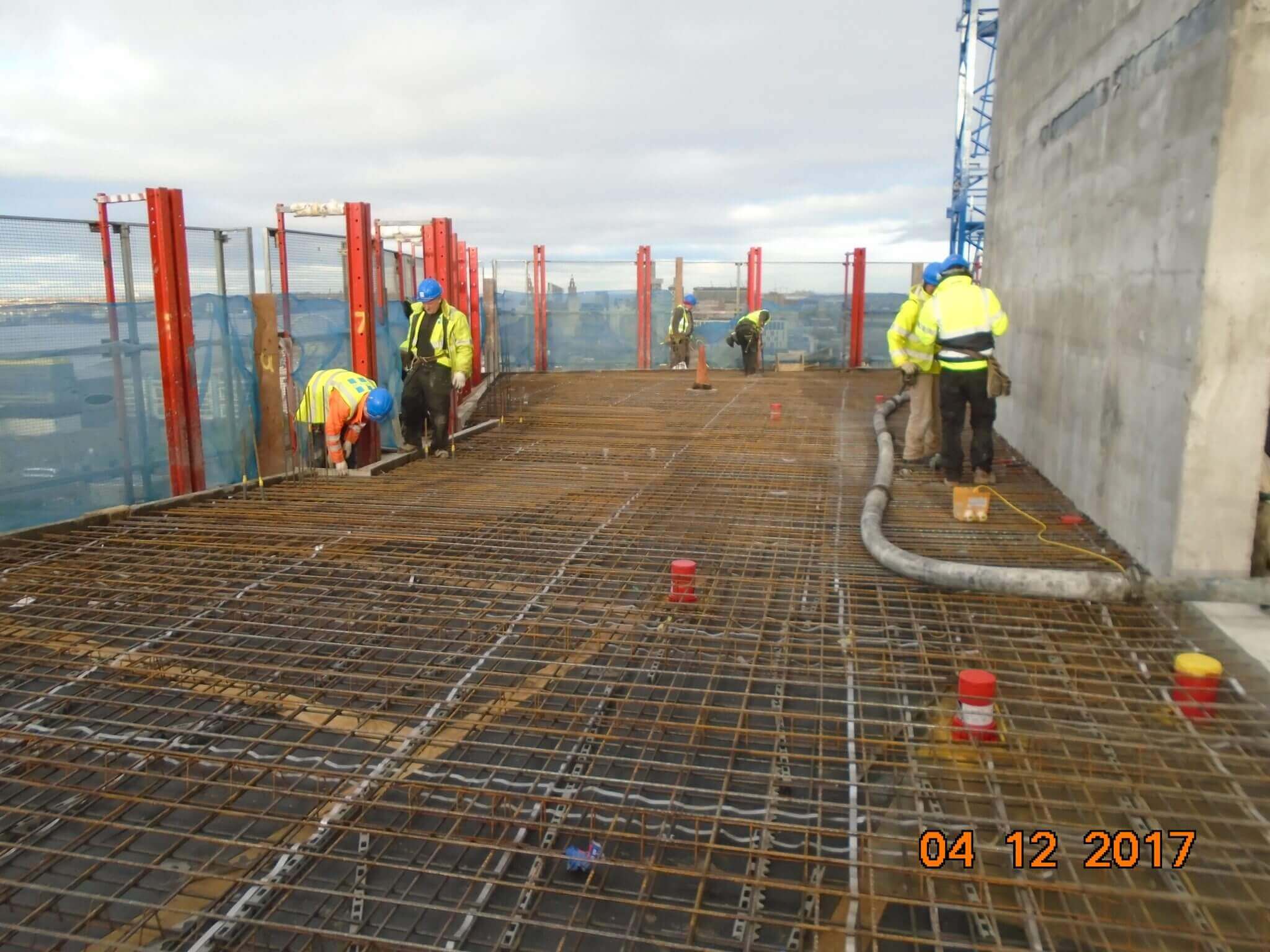

The concrete pour is now complete up to Level 22 with 11 columns poured in total to levels 22 and 23. The bottom of the safety screen has now been lifted to level 21 to commence deck level 23 concrete pour. The Vermont/X1 signs at the top of the lift core have now been removed to allow for the final floors to be cast and there is a continuation of prepping the floors for handover on Levels 15 & 16. Columns on levels 23 and 24 are due to be completed by 13th December with further movement of the safety screen scheduled to commence formwork for level 24 (The roof) concrete pour. Mesh welding is due to be completed in the smoke vent shaft, whilst installation of the geogrid system to the riser remains ongoing. First fix duct work is now on levels 7 and 8 whilst sprinkler works are up to level 11.

Weather permitting Saturday works will occur between 07:00 – 13:00
