Construction Update – Aura – December 2019

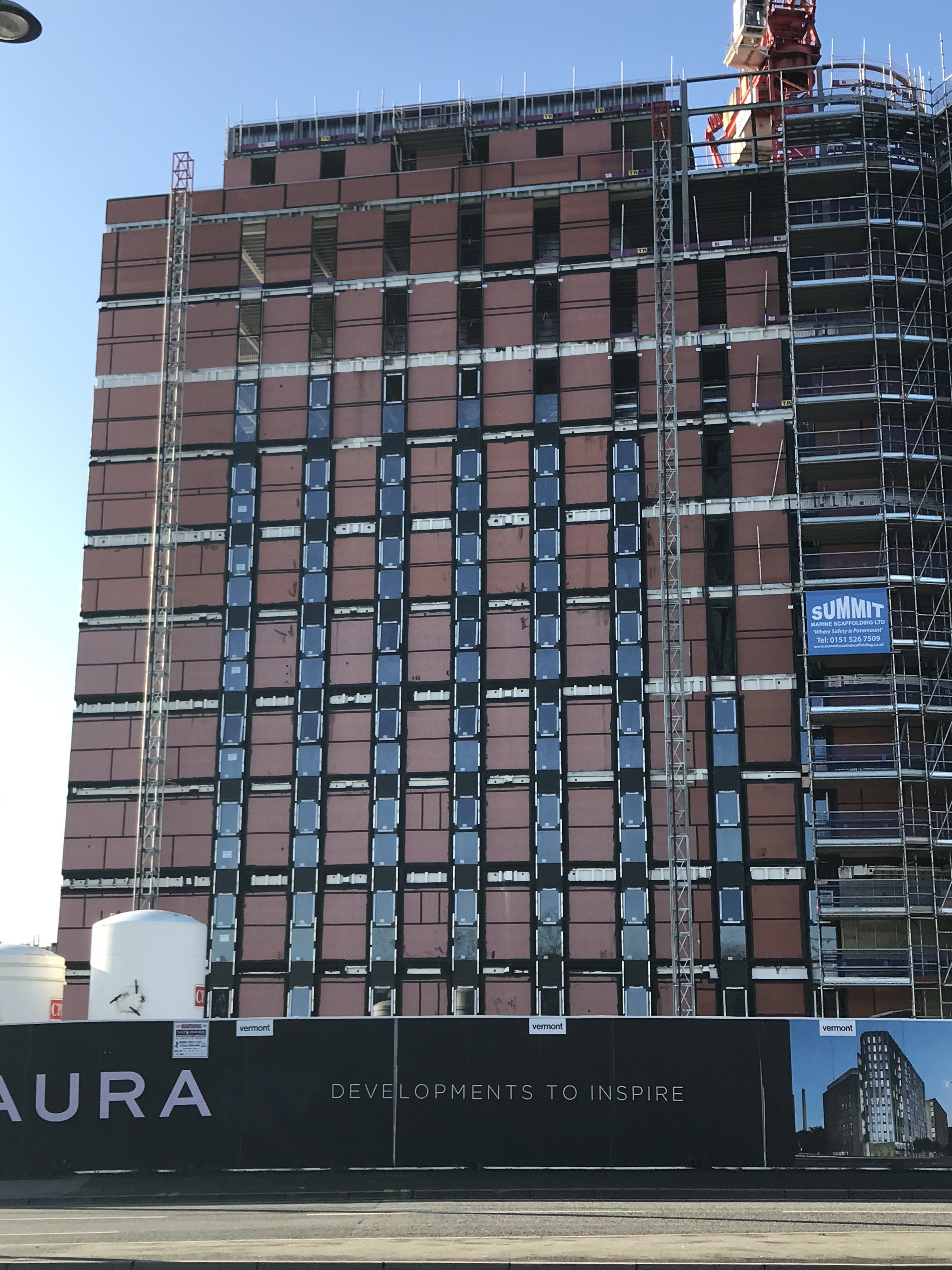

17th December 2019There is good progress to date with the internal partitions and SFS plus weatherboarding. Electrical installs to blocks 1&2 is well under way up to L11.5, block 3 to L7. Brickwork is currently on the 2nd lift masonry to E6, E1 & E3, blocks 2 & 3 gables. The Plant room fit out works commenced with rods to ceiling and insulation to sofit. Lifts 1&2 on target to complete soon.
